BCA and LTA monitoring
Automated ground, structure and slope monitoring for Singapore works
Singapore building works near railways, deep excavations and slopes must monitor ground and structure movement and report it. Kodifly's ScanStation LiDAR watches the site around the clock from a fixed point, compares every scan with the last and alerts your Qualified Person when movement passes the limit you set.

- Ground and structures
- Building Control Regulations, regulation 37
- Railway protection zone
- LTA Code of Practice for Railway Protection
- Automatic monitoring
- Where predicted movement exceeds 5 mm
- 5 mm
- predicted movement above which LTA requires automatic tunnel monitoring.
- 4
- monitoring cycles a day, at least, for that system.
- 24/7

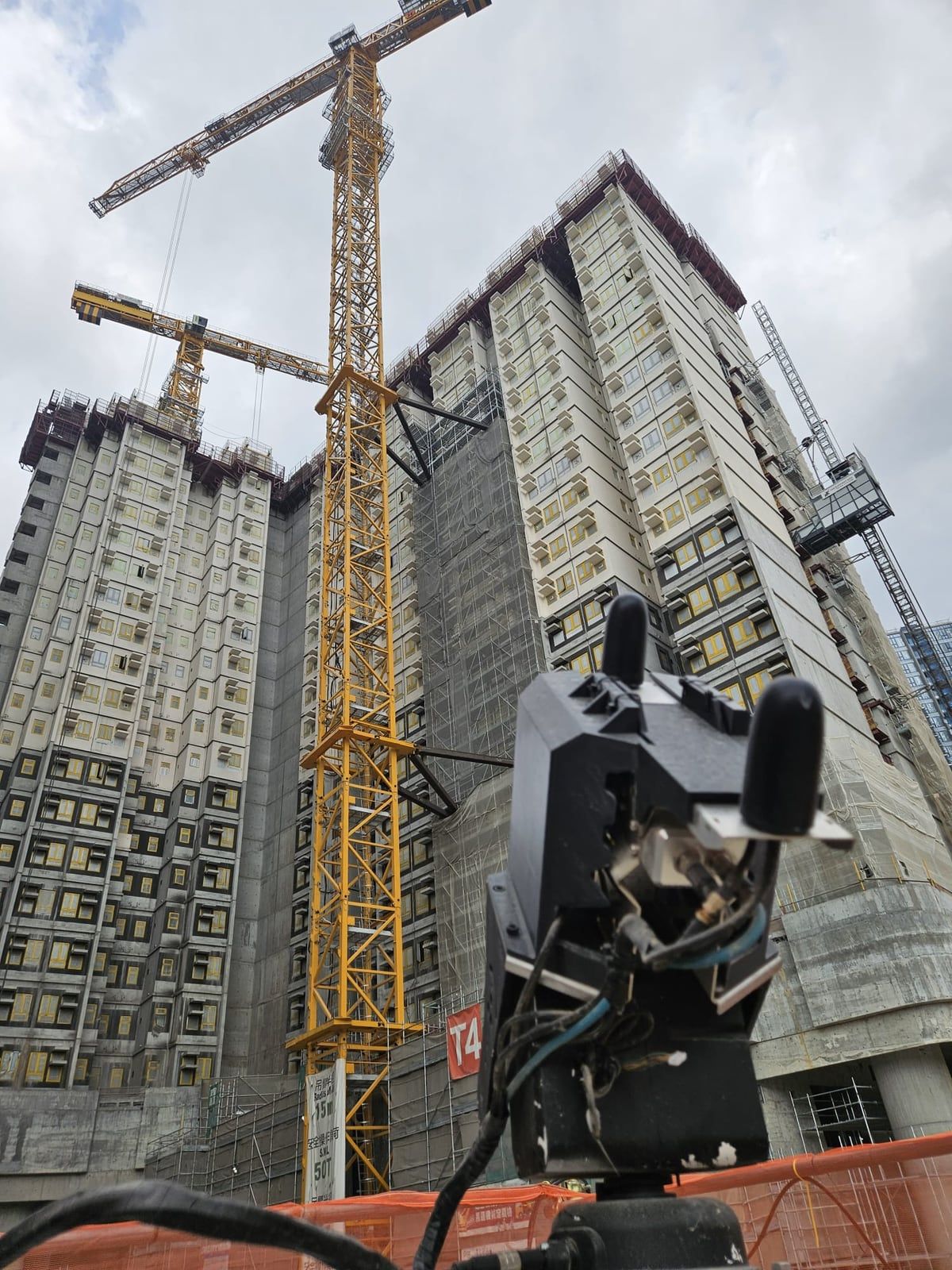

- ScanStation scanning, with alerts on your limits.
What monitoring has to catch.
8 of 8 included
Excavation and shoring movement
Adjacent building movement
Railway protection zone structures
Slopes during building works
Alert limits you set
Immediate notice when a limit is passed
Dated results for the QP's report
Continuous scanning of hot spots
From survey to alert.
Survey and place
We choose the fixed point that sees the whole zone.
Baseline scan
The first scan is the reference for every later one.
Scan around the clock
Every scan is compared with the last, from the same place.
Alert and report
Movement past your limit alerts the QP, and the record is ready to report.
Real movement, not instrument noise.

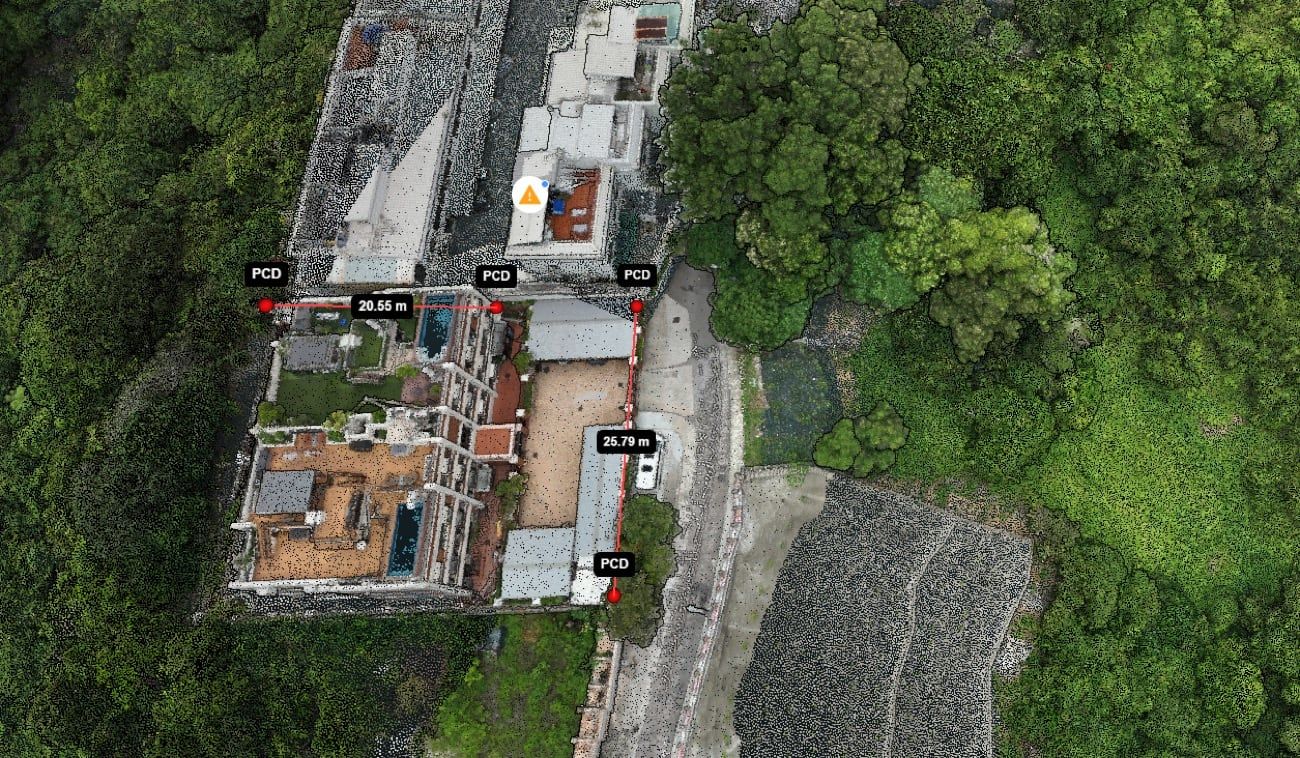

The unit never moves, so every scan is taken from the same place and the difference between two scans is real change on the ground. One dated record shows the whole surface, not only the points you installed instruments on.

Proven on real sites.
- 100+
- sites run Kodifly systems across Asia and the Middle East.
- ~20
- Hong Kong public works contracts run SmartEye on Kodifly sensors.
- Gold
- CIC AI Award 2026 for SmartEye, the platform Kodifly supplies sensors for.
Go deeper
Monitoring questions
What monitoring do Singapore building works need?
The supervising Qualified Person must regularly inspect and analyse the instrumentation for ground and adjacent structures, report the results to the Commissioner of Building Control periodically, and notify the Commissioner when movement passes the allowable limits (Building Control Regulations, regulation 37).
What does LTA ask for near a railway?
Where cumulative movement of an underground or at-grade rapid transit structure is expected to exceed 5 mm, an automatic remote-control monitoring system is required, with at least four cycles of results in 24 hours and a continuous mode for localised areas (Code of Practice for Railway Protection, 6.3.3 and 6.3.4).
Does Kodifly deliver automated monitoring?
Yes. ScanStation scans from a fixed point around the clock and compares every scan with the last. Kodifly installs and runs it, sets the alert limits to your monitoring plan and sends alerts to your Qualified Person.
How does it fit with our instruments?
ScanStation adds a continuous, whole-surface view to inclinometers, settlement markers and survey points, and feeds the same record. Kodifly delivers it alone or alongside them.
What about slopes?
BCA requires a Qualified Person to assess slopes formed or modified by building works for failure risk before construction, and to recommend how the slope is monitored while works continue. ScanStation watches the slope continuously and flags change.
Put a monitoring plan on one screen
Tell us the excavation, rail or slope and your alert limits. We will show you the scan and the alert.
