DEVB TC(W) No. 1/2026
Co-supervision Platform capture, from 4D LiDAR to the SmartEye dashboard
The Co-supervision Platform (SmartEye) is DEVB's remote supervision system for Hong Kong capital works above HK$400 million tendered from 1 April 2026. DEVB provides the SmartEye dashboard. Kodifly supplies the fixed-point, fixed-route and handheld LiDAR, cameras and edge units it runs on, to the CSP Particular Specification, on approximately 20 Hong Kong public works contracts.

- 20
- Hong Kong public works contracts fitted with Kodifly LiDAR, cameras and edge units, approximately.
- 3
- appliance types in the CSP Particular Specification, fixed-point, fixed-route and mobile handheld.
- ±2 cm
- ScanStation range accuracy, 1σ.
- ≤8 cm
- absolute accuracy as RMSE against at least 10 RTK checkpoints, as the specification requires.
Everything the capture side runs on, delivered.
Kodifly delivers the site side of the platform. The dashboard, its software and algorithms are provided by DEVB (CSP Particular Specification, section 1.2.2).
13 of 13 included
Fixed-point ScanStation with camera and pan-tilt head
Fixed-route drone LiDAR
Handheld LiDAR with RTK and SLAM
Edge computer at every capture point
5G bonding across four mobile operators
Lockable enclosure, tamper alarm and UPS
Point clouds in LAS, on the HK1980 Grid
RTK accuracy check by a qualified surveyor
Data for the time series viewer and measurements
Data for rebar, MiC and tower crane checks
AI cameras and IoT sensors on the same feed
Integration with DEVB's SmartEye dashboard (provided by DEVB)
Testing, commissioning and on-site maintenance
From the pole to the project team.
Scan sessions
Harbour View Tower B- Fixed-point LiDAR · Level 51.8 bn points · 06:40Uploaded
- Drone LiDAR · Roof slab640 M points · 07:25Uploaded
- Fixed-point LiDAR · PodiumScanning · 09:10Scanning
SpatialSense AI
4D model- Registered 3 scansAligned to the site gridDone
- Building 4D modelLevel 5 to roof84%
- Changes flaggedCompared with the 12 Oct scan14 found
DWSS records
Remote supervision- Slab pour, Level 5Progress +3.2% · 15 OctRecorded
- Rebar fixing, Level 6Progress +1.8% · 15 OctRecorded
- Formwork off line, grid C-DFor engineer reviewTo review
Sent to the DWSS hub · 15 Oct 2026, 09:42
Three appliance types, one record
The CSP Particular Specification lets a contract use one or more of three main appliances (section 3). Kodifly delivers all three on the same coordinate frame.
Fixed-point
ScanStation K4DL-1000
LiDAR and camera on a pan-tilt head, on poles or tower cranes, watching one area over time.
Mobile
Handheld LiDAR with RTK
Handheld scans with RTK outdoors and SLAM indoors, for areas no fixed unit or drone route reaches.
Security and privacy, built in
What the CSP Particular Specification asks for, and what Kodifly delivers on every contract.
Assessments
- Security Risk Assessment and Audit against the Government IT Security Policy and Guidelines (Appendix A2, section 6).
- Privacy Impact Assessment under the Personal Data (Privacy) Ordinance, Cap. 486 (Appendix A2, section 6).
On the devices
- Face masking enabled on every colour camera (Appendix A1, 1.2(b)).
- Camera encryption, WiFi with WPA3 and AES, and TLS on LoRaWAN links (A1 1.2(b) and (e); A2 1.6).
- Lockable enclosure with a tamper alarm to SMS and the dashboard within 5 seconds (A1 1.2(g)).
At handover
- The DWSS handover and technical audit requirements apply to the CSP (TC(W) No. 1/2026, paragraph 16).
- Kodifly hands over the record and documents, then erases site devices before removal.
Check a tender clause by clause
CSP Particular Specification
The specification, clause by clause
Every hardware, accuracy, testing, maintenance and security clause, and how Kodifly meets it.
TC(W) No. 1/2026, Annex A
Platform functions
The nine Annex A functions, project-specific additions and optional items.
Capture equipment in the field

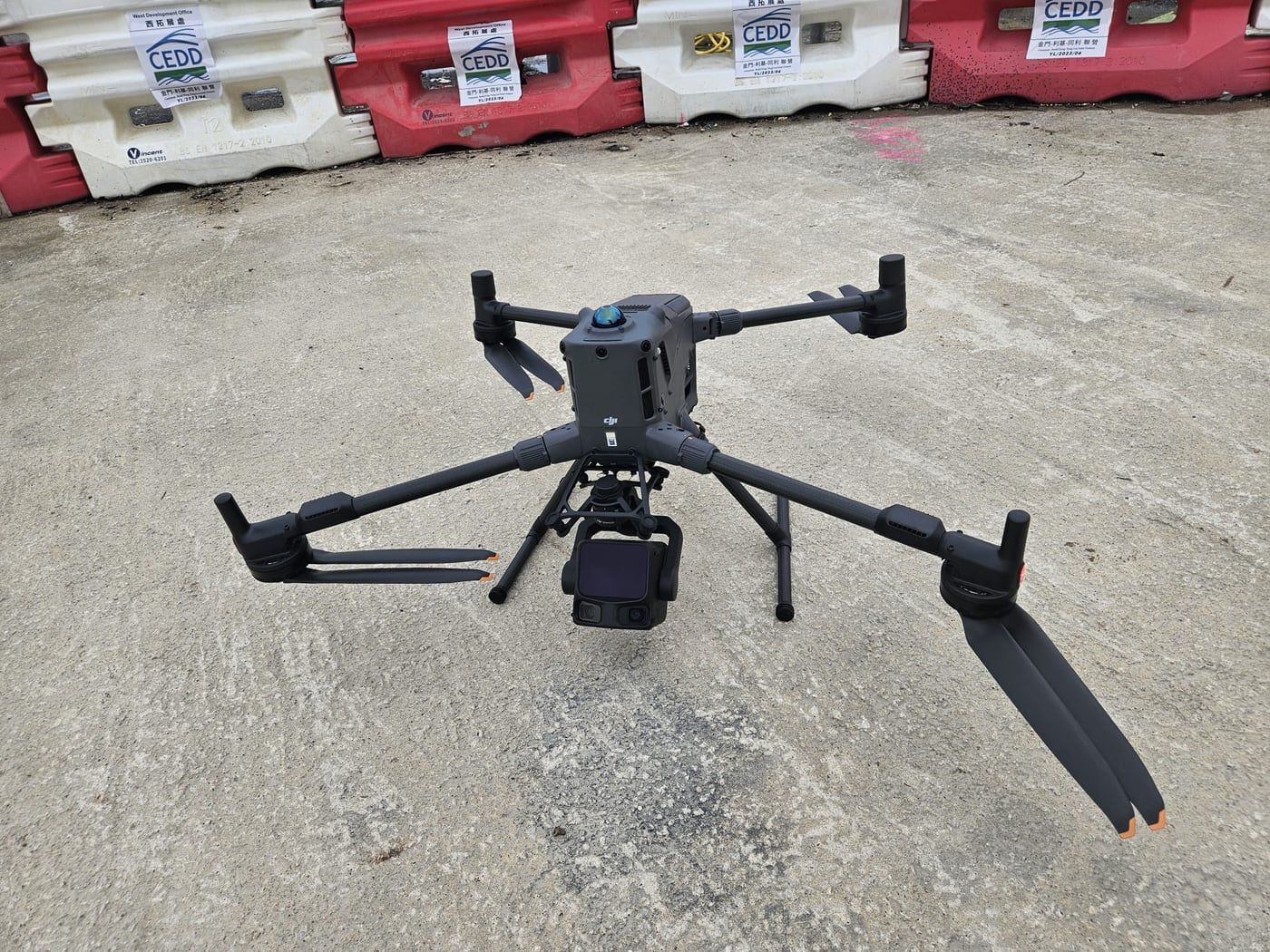

Survey drone at a public works site.
Site unit being installed on a tower crane.
LiDAR unit and equipment cabinet on a pole at a public works site.
Fixed-point LiDAR facing residential blocks under construction.
Plan the capture for your site
Discuss site captureRecognition
SmartEye won the CIC AI Award 2026 Gold Award.
SmartEye, DEVB's Co-supervision Platform, won the Gold Award in the AI Research and Development (Quality Inspection) category of the CIC AI Award 2026, presented at the CIC Global AI and Smart Construction Conference and Exhibition on 24 and 25 June 2026. Kodifly is a supporting partner of SmartEye.
- SmartEye is developed in-house by DEVB. The award is DEVB's.
- Kodifly supplies the LiDAR, cameras and edge units on about 20 Hong Kong public works contracts.

The Kodifly team with the Development Bureau team and the CIC AI Award 2026 at the SmartEye booth.
Guides and detail pages
Deployments
Kodifly has fitted around 20 Hong Kong public works contracts with LiDAR, cameras and edge units for the Co-supervision Platform. Departments, scope and how we deploy.
Fixed-point vs fixed-route
TC(W) No. 1/2026 allows fixed-point LiDAR on poles or tower cranes and fixed-route LiDAR on drones or robots. When to use each, blind spots, and how Kodifly plans both.
Functions
The nine Co-supervision Platform functions and four SmartEye technologies in TC(W) No. 1/2026 Annex A, the site data each needs, and how Kodifly supplies it.
Particular Specification
What the CSP Particular Specification under DEVB TC(W) No. 1/2026 requires, clause by clause, from LiDAR and edge hardware to accuracy, testing and security.
Scope and vetting
TC(W) No. 1/2026 requires the Co-supervision Platform for capital works above HK$400 million tendered from 1 April 2026. Scope, vetting, exemptions and the DWSS link.
SmartEye compatible capture
What capture data SmartEye, DEVB's Co-supervision Platform, needs under TC(W) No. 1/2026, and how Kodifly's LiDAR, cameras, sensors and edge units deliver it.
Case studies and news

News ·
Spatial AI for Built Environment at HKSTP: our takeaways
Takeaways from HKSTP's Spatial AI for Built Environment session on 6 November 2026: CSDI data, LiDAR, point clouds, BIM and digital twins in Hong Kong.

News ·
Kodifly at HKSTP lunch with Singapore Minister Josephine Teo
Kodifly joined an HKSTP lunch exchange with Singapore's Minister for Digital Development and Information, Josephine Teo, on AI and digitalisation in both cities.
Slope movement against trigger levels.
Soil nail heads and rock anchors carry their displacement over six weeks. Alert, alarm and action levels sit on the trend, and a crossing raises an alert to acknowledge.
Station health on one panel.
Tamper alert within 5 seconds, a four-SIM bonded uplink, UPS runtime and LAS export in HK1980 show together, so a fault shows before a scan is missed.
Co-supervision Platform questions
What is the Co-supervision Platform?
It is DEVB's remote supervision platform for smart construction management under TC(W) No. 1/2026. Its Video of Point Cloud uses 4D LiDAR to capture the spatial data of a site over time, so works departments, consultants and contractors can check workmanship, productivity, positions and dimensions off site (paragraph 7).
Who must adopt the Co-supervision Platform?
Capital works contracts with a pre-tender estimate above HK$400 million and tendered on or after 1 April 2026 (paragraph 10). Other new or ongoing capital works contracts are encouraged to adopt it as far as practicable, and maintenance and term contracts may adopt it where applicable (paragraphs 10 and 11).
What functions does the platform have?
Annex A lists nine, a time series point cloud viewer, dimension and volume measurement, slope angle and ground profile measurement, reinforcement bar fixing check, MiC installation productivity check, tower crane efficiency check, an alerts system, site report generation and an AI chatbot. They run on DEVB's dashboard. Kodifly delivers the 4D LiDAR capture and site data they run on.
What does the CSP Particular Specification require?
It sets the site hardware and services for the platform. That means three appliance types, the LiDAR, camera, edge computer, 5G bonding, enclosure and UPS, data in the HK1980 Grid and LAS format, and absolute accuracy of 8 cm or better as RMSE against at least 10 RTK checkpoints (Appendix A1, 1.1(f)). It also sets testing, maintenance, SRAA and PIA. The dashboard is provided by others (section 1.2.2).
Which capture approaches does the circular describe?
The 4D LiDAR Video of Point Cloud can be produced with a fixed-point approach, LiDAR on fixed poles, tower cranes or other non-movable objects, or a fixed-route approach, small unmanned aircraft flown on a set route to minimise blind spots (Annex A, paragraph 2(i)). The CSP Particular Specification adds a third appliance, a mobile handheld LiDAR scanner with RTK. Kodifly delivers all three, planned together.
Is the Co-supervision Platform the same as SmartEye?
In DEVB's circular, SmartEye is the in-house solution that establishes the Co-supervision Platform. Other vendors sell products with similar names, so check that you are dealing with DEVB's platform.
Who decides the scope for my project?
The project office defines the scope of functions suited to the works, using DEVB's sample specification and consulting Works Policies 4 Section. The proposed scope and draft tender provisions go to that section for vetting, until March 2028 or a date DEVB announces (paragraphs 14 and 15).
What sensors does the platform use besides LiDAR?
It can retrieve and analyse data from AI cameras, body-worn cameras, IoT sensors for temperature, humidity and vibration, and other devices such as thermal sensors, fibre optic sensors and handheld laser scanners (Annex A, paragraph 3). Kodifly delivers these on the same platform.
How does it connect to the DWSS?
The platform connects with the Smart Construction Management hub of the DWSS by API or other means. DWSS acceptance, handover, technical audit and iCWP requirements apply to it (paragraph 16).
Can a short or small contract be exempted?
Yes, on exceptional grounds such as a short construction period, changing site locations or minimal works content, with policy consent from DEVB's Works Policies 4 Section (paragraph 17).
Also on a public works site
TC(W) No. 8/2025
Digital Works Supervision System
How the DWSS passes site data to iCWP within 24 hours.
Plan the capture for your site
Tell us the site, works type and tender date. We will plan fixed-point, fixed-route and handheld capture.
